UCMP Hartford
en EspaƱol (PDF)
Why Are We Doing This Project?
As part of our ongoing commitment to deliver reliable energy and superior service, we are replacing two existing 115-kilovolt (kV) underground transmission lines in the Hartford area.
These two existing transmission lines, installed in 1974, are past their expected operating life of 40 years and the material is no longer being widely produced by manufacturers.
Construction and Traffic Updates
This work will not interrupt your electric service, and all people working on this project are Eversource-approved contractors who carry proper identification.
Schedules are subject to change. This information is current as of January 7.
Work being done January 12 - 16
Monday through Friday, you may see crews:
We are actively working on the following streets, performing excavation and concrete backfill as part of the duct bank and vault installation process:
- Scarborough St.
- South Whitney St. between Capitol Ave and Park St.
- Whitney St between Farmington Ave and Fern St.
- South Whitney Street & Capitol Ave Intersection
- Whitney Street & Fern St Intersection
Tree removal work will continue on Whitney St.
Please follow local traffic signage.
Temporary street closure and parking restrictions may be placed on the following streets. All roads are open to local traffic only. Pedestrian traffic has shifted. Please pay attention to posted signage. Please follow detour signs:
- Scarborough St. between Albany Ave and Asylum Ave
- South Whitney St. between Capitol Ave and Park St.
- Whitney St between Farmington Ave and Fern St.
- South Whitney & Capitol Ave Intersection
- South Whitney & Fern St Intersection
All residents will have access to their homes and businesses.
Work hours:
7 AM to 5 PM, Monday through Friday.
9 AM to 6 PM- Scarborough St.
Starting January 12, construction at South Whitney St and Capital Ave will run 24 hours a day Monday–Friday to reduce the overall duration of construction. The intersection will stay closed on weekends for public safety due to the large excavation.*
*Locations and hours are subject to change based on weather and other unforeseen circumstances.



About this project

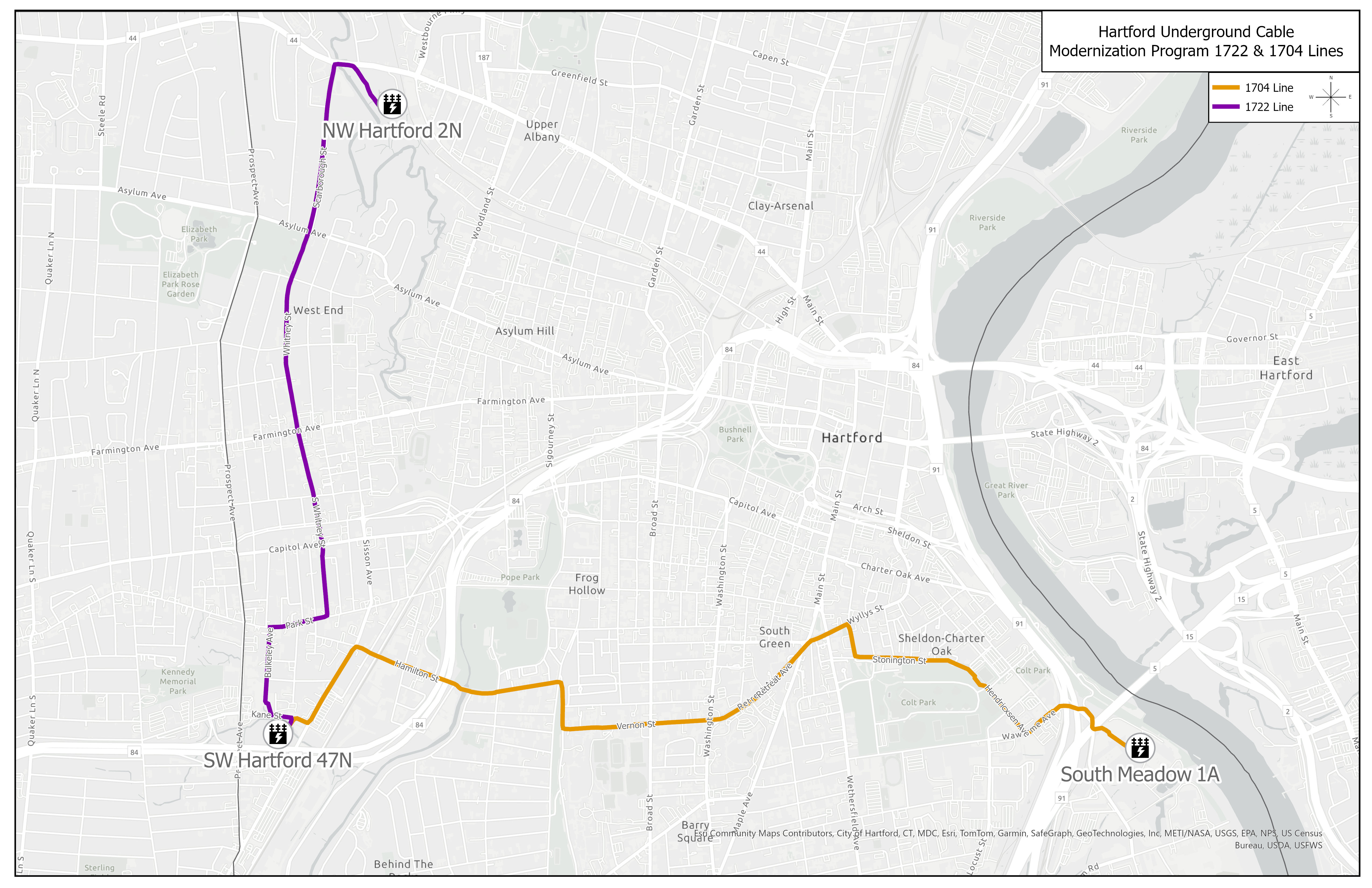

- Route length: 7 miles
- Line voltage: 115 kilovolts (kV)
- Siting review by: Connecticut Siting Council (CSC)
When Is The Work Being Done?
- Petition filing to CSC: December 29, 2023
- CSC filing decision: June 2024
- Start of construction: April 2025
- Construction completion: Mid-2027*
- Commissioning: Late 2027*
- Project restoration: Mid-2028*
*Subject to change, pending necessary approvals
Community Outreach
We are committed to engaging city officials, residents, businesses, community groups and other interested stakeholders about the project through meaningful engagement. Our team strives to incorporate local feedback as feasible.
Project team members will remain engaged with the community to provide schedule updates and address questions and concerns. Information is available in Spanish and other languages upon request.
