Cross Road Substation Upgrade

Why Are We Doing This Project?

We determined after an extensive study that integration of additional clean energy into the electrical grid in the Dartmouth area requires upgrades to our Cross Road Substation. This project will optimize system stability and improve reliability.

This work is part of a larger initiative focused on electric system enhancements to maintain reliability and enable distributed energy resource (DER) facilities to safely interconnect and operate.

Where Is This Work Being Done?

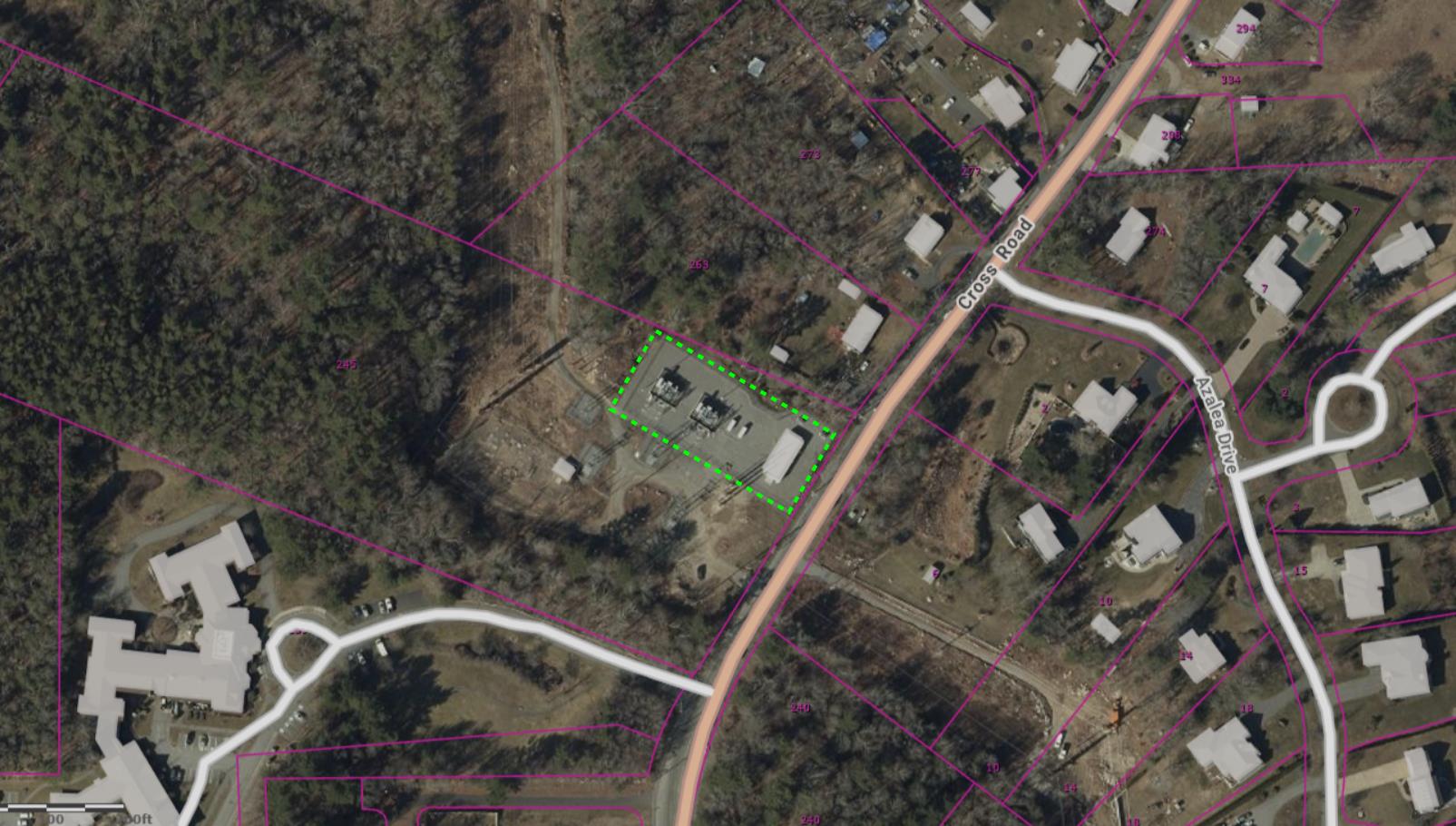

Upgrades to our Cross Road Substation on Cross Road in Dartmouth will take place within the existing substation fence boundaries and include:

  • Installing two three-phase series reactors
  • Installing new foundations
  • Trenching, to install new conduits
  • Relocating the existing capacitor banks within the substation

About this project

  • Location: Cross Road, Dartmouth
  • Construction duration: 11 months*

*Approximate, subject to change

For more information, download a project fact sheet (PDF).

When Is The Work Being Done?

  • Proposed start of construction: Q1 2026
  • Estimated in-service date: Q1 2027

*Subject to change, pending necessary approvals

Siting Review

Dates

  • Town of Dartmouth Building Permit: Pending

Community Outreach

We are planning engagement with town officials, residents, businesses, community groups and other stakeholders via municipal briefings, mailings and meetings to answer questions and listen to concerns.

Join the email list for regular updates

Have Questions?

Keeping the lines of communication open is an important part of our work in your community. We welcome input from the community.

For more information about this project, please call the project information hotline at 833-836-0302 or email ProjectInfoMA@eversource.com.
